LCP Practical ConstructionLEAN CONSTRUCTION PROCEDURES (LCP®)

LEAN Root Cause Analysis

Drilling Down in LEAN - RCA

The key to any improvement is here How do we remove the LEAN waste wood from the trees?


Jidoka  Also referred to as autonomation, it is adding the human element of being able to identify problems and either stop for correction or self-correct before moving onto the next step.

Kaizen Kaizen is a structured process to engage those closest to the process to improve both the effectiveness and efficiency of the process. Its goals are often to remove waste and add standardizatio

Poke-yoke Mistake-proofing. A way to prevent poor quality in a process

Waste Elimination Eliminating waste from the process is the goal of many lean tools and should be an on-going effort in itself. This comes in the form of the seven types of waste: overproduction, waiting, inventory, overprocessing, motion, transportation and defect

Yaruki The attitude of "Can do" - everything is achievable


In order to expose the waste we must have visibility of the process performance. This can be done in several ways in construction. Consider how complex and how manty threads there are for example;

The list of potential data collected on the projects performance is endless - and all of it is shouting out about areas that require your attention. The challenge for any project team is direct their focus on areas that will make EFFECTIVE changes - rather than bring limited EFFICIENCY from the LEAN Construction Procedures. By recognising that many of the causes of constraints to achieving a more effective performance are in "groups of influence" is the root to providing a way forward to making a radical reduction in waste. The results of Risk Ripple - is a good demonstration of this effect in action.

By capturing data in "groups of Influence" areas demanding focus can be more easily identified and actioned. The Root Cause analysis chart from a past project shown above demonstrates this. Over one quarter of problems caused on this site was from the lack of available resource. Does it require more labour? An "easy fix" - but would it be effective?

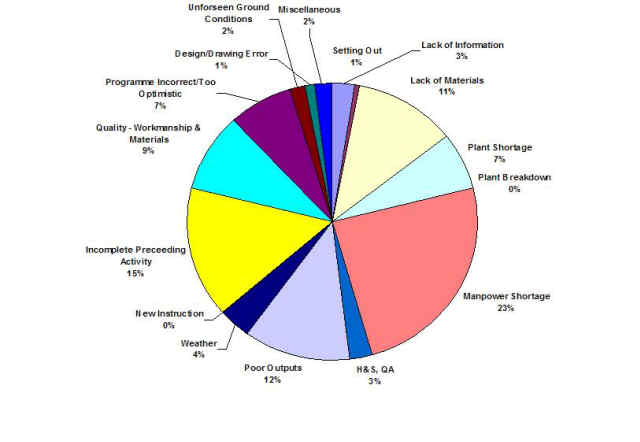

LEAN RCA

In this instance the Root Cause is deeper. It can be seen by exploring and recognising the Groups of Constraints.

  • Manpower Shortage
  • Plant Shortage
  • Incomplete Proceeding Activity
  • Programme Incorrect / Too Optimistic
  • Lack of Information
  • Lack of Materials

These have their Roots in effective Programming and Preparation. Collectively they are resposible for an astonishing 73% of the CONSTRAINTS

A focus was placed on improving both the main Programme and the weekly forecast supported by process mapping and analysing KEY Critcal activity chains ahead of build. This brought a radical reduction in the more effective use of resource and eliminated the Waste caused by less than effective programming.
